library(dplyr)
library(ggplot2)
library(purrr)
library(stringr)
library(tibble)
library(tidyr)
source("R/lesson-figures.R")
program_entries <- tribble(
~entry_id, ~entry_date, ~entry_text,
"R01", "2026-02-20",
"The spring outreach window will run this spring.",
"R02", "2026-03-03",
"The orientation was held on March 2, and registration closes on March 15.",
"R03", "2026-08-28",
"The 12-week course starts on September 14.",
"R04", "2026-09-20",
"The reminder says the applicant check-in happened last Monday.",
"R05", "2026-10-05",
"The pilot lasted six weeks.",
"R06", "2026-10-10",
"The October review meeting is planned for October 22.",
"R07", "2026-11-01",
"The November report covers work completed in September."
) |>
mutate(entry_date = as.Date(entry_date))Putting events on a timeline
Keep document dates, event dates, and uncertain durations apart
The pilot lasted six weeks looks ready for a timeline until Nadia asks when the six weeks began. Other entries report a day, a month, or a season.
Placing events on a timeline means using a time scale at the precision the text provides. A day can be a point. A month, season, or course length needs an interval. A duration with no start date stays off the time scale.
This lesson uses a small constructed log so readers can examine the dates. It builds on the temporal parsing lesson, which explains reference dates for phrases such as βnext Friday.β
The Riverton program log is a constructed teaching example about an invented service desk. The lessonβs author wrote the entries and normalized dates.
This lesson shows how to:
- distinguish a noteβs date from the date of its event
- resolve relative dates from each noteβs own date
- draw seasons, months, and course lengths as intervals
- mark planned and reported events without relying on colour alone
- show an undated event without guessing its position
- compare the order of the notes with the order of the events.
Build a small event log
An entry date is the date of the note. It provides the reference for relative language, not necessarily the event date. Every row retains its entry_id, so readers can find the source sentence for each timeline mark.
| Entry ID | Entry date | Constructed log entry |
|---|---|---|
| R01 | 2026-02-20 | The spring outreach window will run this spring. |
| R02 | 2026-03-03 | The orientation was held on March 2, and registration closes on March 15. |
| R03 | 2026-08-28 | The 12-week course starts on September 14. |
| R04 | 2026-09-20 | The reminder says the applicant check-in happened last Monday. |
| R05 | 2026-10-05 | The pilot lasted six weeks. |
| R06 | 2026-10-10 | The October review meeting is planned for October 22. |
| R07 | 2026-11-01 | The November report covers work completed in September. |
The second entry has two events and two dates. The orientation belongs to March 2. The registration closing belongs to March 15. Reading only the nearest date would fail on many real sentences. Here, the author records each dateβs event association manually.
Normalize only dates with source evidence
The event table names each event indicator, time expression, and date-calculation rule. The season rule is a local convention. This page uses Northern Hemisphere meteorological seasons, so spring extends from March 1 through May 31.
season_bounds <- tribble(
~season, ~start_month, ~start_day, ~end_month, ~end_day,
"spring", 3L, 1L, 5L, 31L,
"summer", 6L, 1L, 8L, 31L,
"autumn", 9L, 1L, 11L, 30L,
"winter", 12L, 1L, 2L, 28L
)
event_plan <- tribble(
~event_id, ~entry_id, ~trigger, ~time_text, ~granularity, ~status, ~rule,
"EV01", "R01", "outreach window", "this spring", "season", "planned",
"entry-year spring",
"EV02", "R02", "orientation held", "March 2", "day", "reported",
"entry-year month day",
"EV03", "R02", "registration closes", "March 15", "day", "planned",
"entry-year month day",
"EV04", "R03", "12-week course", "September 14 for 12 weeks", "duration",
"planned", "entry-year month day plus weeks",
"EV05", "R04", "applicant check-in", "last Monday", "day", "reported",
"previous weekday from entry date",
"EV06", "R05", "pilot lasted", "six weeks", "duration", "reported",
"duration without start",
"EV07", "R06", "review meeting", "October 22", "day", "planned",
"entry-year month day",
"EV08", "R07", "September work", "September", "month", "reported",
"entry-year month"
)
make_date <- function(year, month, day) {
as.Date(sprintf("%04d-%02d-%02d", year, month, day))
}
parse_month_day <- function(entry_date, time_text) {
parts <- str_match(time_text, "\\b([A-Z][a-z]+)\\s+(\\d{1,2})\\b")
make_date(
as.integer(format(entry_date, "%Y")),
match(parts[, 2], month.name),
as.integer(parts[, 3])
)
}
parse_month_interval <- function(entry_date, time_text) {
month_number <- match(time_text, month.name)
start <- make_date(as.integer(format(entry_date, "%Y")), month_number, 1L)
end <- seq(start, by = "1 month", length.out = 2L)[2] - 1L
list(start = start, end = end)
}
previous_weekday <- function(entry_date, weekday) {
weekday_names <- c(
"Sunday", "Monday", "Tuesday", "Wednesday",
"Thursday", "Friday", "Saturday"
)
current_day <- as.POSIXlt(entry_date)$wday + 1L
target_day <- match(weekday, weekday_names)
days_back <- (current_day - target_day) %% 7L
if (days_back == 0L) {
days_back <- 7L
}
entry_date - days_back
}
placed_interval <- function(start, end) {
list(start = start, end = end, placed = TRUE, reason_unplaced = NA_character_)
}
normalize_event <- function(rule, entry_date, time_text) {
entry_year <- as.integer(format(entry_date, "%Y"))
if (rule == "entry-year spring") {
bounds <- season_bounds |>
filter(season == "spring")
return(placed_interval(
make_date(entry_year, bounds$start_month, bounds$start_day),
make_date(entry_year, bounds$end_month, bounds$end_day)
))
}
if (rule == "entry-year month day") {
day <- parse_month_day(entry_date, time_text)
return(placed_interval(day, day))
}
if (rule == "entry-year month day plus weeks") {
start <- parse_month_day(entry_date, time_text)
return(placed_interval(start, start + 12L * 7L - 1L))
}
if (rule == "previous weekday from entry date") {
day <- previous_weekday(entry_date, "Monday")
return(placed_interval(day, day))
}
if (rule == "entry-year month") {
interval <- parse_month_interval(entry_date, time_text)
return(placed_interval(interval$start, interval$end))
}
list(
start = as.Date(NA),
end = as.Date(NA),
placed = FALSE,
reason_unplaced = "duration has no start date"
)
}
event_rows <- event_plan |>
left_join(program_entries, by = join_by(entry_id)) |>
mutate(
normalized = pmap(list(rule, entry_date, time_text), normalize_event),
start = as.Date(map_chr(normalized, \(item) as.character(item$start))),
end = as.Date(map_chr(normalized, \(item) as.character(item$end))),
placed = map_lgl(normalized, "placed"),
reason_unplaced = map_chr(normalized, "reason_unplaced"),
narrative_order = match(entry_id, program_entries$entry_id)
) |>
select(
event_id, entry_id, narrative_order, entry_date, trigger, time_text,
granularity, status, rule, start, end, placed, reason_unplaced
)| Event ID | Entry ID | Entry date | Event trigger | Time text | Granularity | Status | Rule | Start | End | Reason not placed |
|---|---|---|---|---|---|---|---|---|---|---|
| EV01 | R01 | 2026-02-20 | outreach window | this spring | season | planned | entry-year spring | 2026-03-01 | 2026-05-31 | NA |
| EV02 | R02 | 2026-03-03 | orientation held | March 2 | day | reported | entry-year month day | 2026-03-02 | 2026-03-02 | NA |
| EV03 | R02 | 2026-03-03 | registration closes | March 15 | day | planned | entry-year month day | 2026-03-15 | 2026-03-15 | NA |
| EV04 | R03 | 2026-08-28 | 12-week course | September 14 for 12 weeks | duration | planned | entry-year month day plus weeks | 2026-09-14 | 2026-12-06 | NA |
| EV05 | R04 | 2026-09-20 | applicant check-in | last Monday | day | reported | previous weekday from entry date | 2026-09-14 | 2026-09-14 | NA |
| EV06 | R05 | 2026-10-05 | pilot lasted | six weeks | duration | reported | duration without start | NA | NA | duration has no start date |
| EV07 | R06 | 2026-10-10 | review meeting | October 22 | day | planned | entry-year month day | 2026-10-22 | 2026-10-22 | NA |
| EV08 | R07 | 2026-11-01 | September work | September | month | reported | entry-year month | 2026-09-01 | 2026-09-30 | NA |
Seven events receive dates. One duration does not. The start and end columns make the difference visible: a day has the same start and end. The spring and September intervals cover only the season or month named in the entry. Only the 12-week course interval is a known duration.
The βpilot lasted six weeksβ row gives a duration but no start date. Nadia keeps that event in the table. The timeline gives it a row without an event mark instead of guessing its position.
Draw the notes and the events together
The timeline gives every event a row in event-date order, with the undated pilot last. Rows distinguish entry dates from event dates. A grey diamond marks the noteβs date. A dotted line connects that diamond to the described event. Points represent days. Bars represent seasons, months, and the course duration.
Status does not depend on colour alone. Hollow points or dashed bars represent planned events. Filled points or solid bars represent reported events.
In this constructed log, every reported event precedes its note, and every planned event follows its note. Dotted lines therefore point backward for reported events and forward for planned events. Real notes can describe ongoing work or record a plan after an event. Examine line direction. Do not assume that the direction shows status.
status_colours <- c(
planned = lesson_colours[["accent"]],
reported = lesson_colours[["contrast"]]
)
timeline_rows <- event_rows |>
arrange(!placed, start, end, event_id) |>
mutate(
row_label = str_c(str_to_sentence(trigger), " (", entry_id, ")"),
row_label = factor(row_label, levels = rev(row_label)),
# The dotted line runs from the note to the nearest edge of the event.
link_end = case_when(
!placed ~ as.Date(NA),
start > entry_date ~ start,
end < entry_date ~ end,
TRUE ~ entry_date
)
)

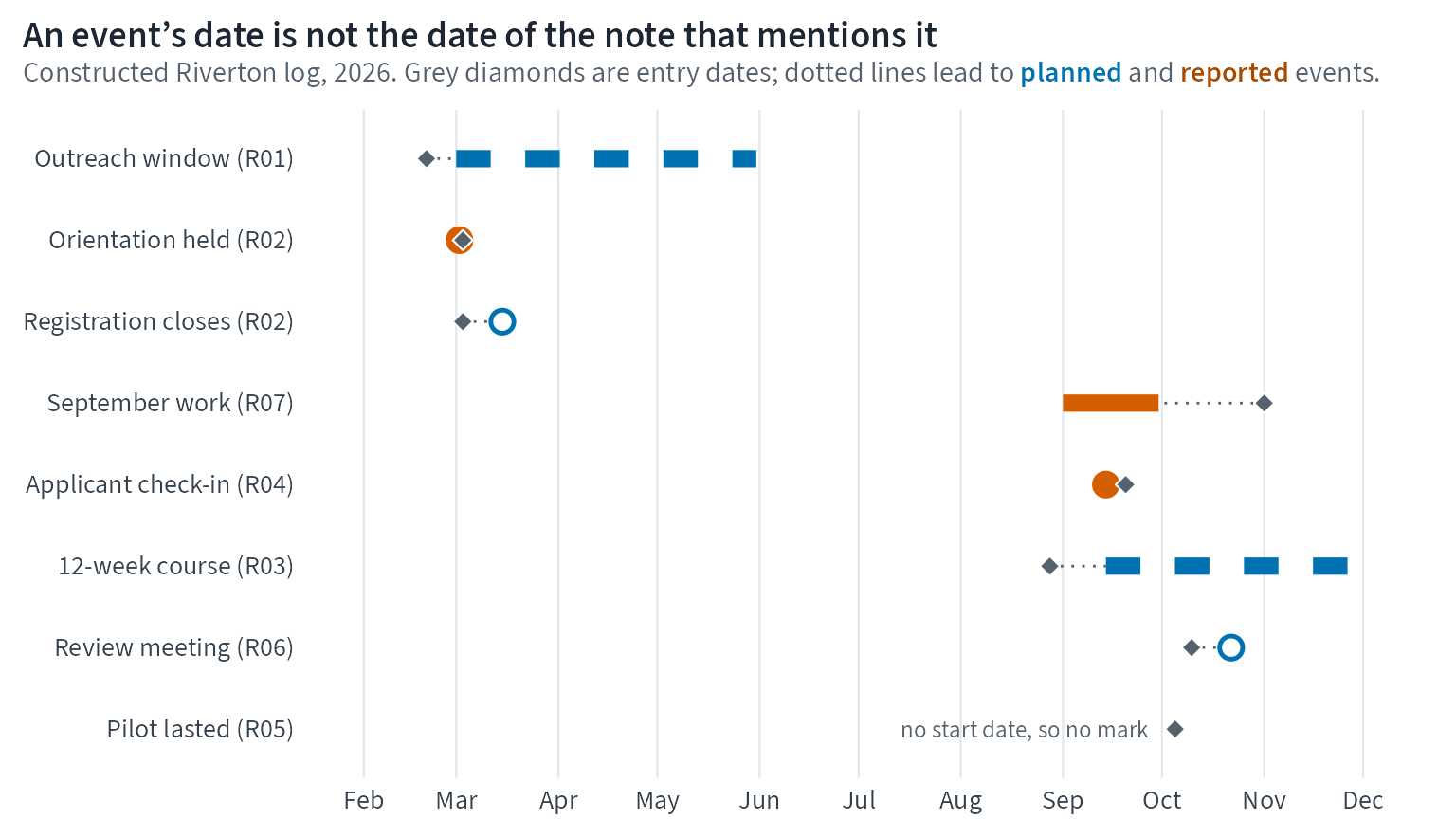

timeline_plot <- ggplot(timeline_rows, aes(y = row_label)) +
geom_segment(
data = \(d) filter(d, placed),
aes(x = entry_date, xend = link_end),
colour = lesson_colours[["muted"]],
linewidth = 0.5,
linetype = "dotted"
) +
geom_segment(
data = \(d) filter(d, placed, granularity != "day"),
aes(x = start, xend = end, colour = status, linetype = status),
linewidth = 3.2
) +
geom_point(
data = \(d) filter(d, placed, granularity == "day"),
aes(x = start, colour = status, shape = status),
size = 3.4,
stroke = 1.3,
fill = lesson_colours[["paper"]]
) +
geom_point(
aes(x = entry_date),
shape = 23,
size = 2.6,
fill = lesson_colours[["muted"]],
colour = lesson_colours[["paper"]]
) +
geom_text(
data = \(d) filter(d, !placed),
aes(x = entry_date, label = "no start date, so no mark"),
hjust = 1,
nudge_x = -8,
family = lesson_font,
size = 9.5,
size.unit = "pt",
colour = lesson_colours[["muted"]]
) +
scale_y_discrete(drop = FALSE) +
scale_colour_manual(values = status_colours) +
scale_linetype_manual(values = c(planned = "22", reported = "solid")) +
scale_shape_manual(values = c(planned = 21, reported = 19)) +
scale_x_date(
date_breaks = "1 month",
date_labels = "%b",
limits = as.Date(c("2026-01-15", "2026-12-20")),
expand = expansion(mult = 0)
) +
labs(
title = "An event's date is not the date of the note that mentions it",
subtitle = str_c(
"Constructed Riverton log, 2026. Grey diamonds mark entry dates. ",
"<br>Dotted lines connect notes to ",
lesson_key("planned", lesson_text_colours[["accent"]]),
" and ",
lesson_key("reported", lesson_text_colours[["contrast"]]),
" events."
),
x = NULL,
y = NULL
) +
theme_lesson(grid = "x") +
theme(legend.position = "none")
timeline_plot
Rows follow event order. Each label also names its source entry, preserving the order of the notes. The November report is entry R07, but its September work appears above the October review meeting. Its dotted line connects backward from November. Note order therefore differs from event order.
The event table is the long description for the figure. It gives the exact dates, status, and entry ID for each mark.
timeline_long_description <- timeline_rows |>
mutate(event_order = if_else(placed, row_number(), NA_integer_)) |>
select(
event_order, narrative_order, event_id, entry_id, entry_date, trigger,
time_text, granularity, status, start, end
)| Event order | Narrative order | Event ID | Entry ID | Entry date | Event trigger | Time text | Granularity | Status | Start | End |
|---|---|---|---|---|---|---|---|---|---|---|
| 1 | 1 | EV01 | R01 | 2026-02-20 | outreach window | this spring | season | planned | 2026-03-01 | 2026-05-31 |
| 2 | 2 | EV02 | R02 | 2026-03-03 | orientation held | March 2 | day | reported | 2026-03-02 | 2026-03-02 |
| 3 | 2 | EV03 | R02 | 2026-03-03 | registration closes | March 15 | day | planned | 2026-03-15 | 2026-03-15 |
| 4 | 7 | EV08 | R07 | 2026-11-01 | September work | September | month | reported | 2026-09-01 | 2026-09-30 |
| 5 | 4 | EV05 | R04 | 2026-09-20 | applicant check-in | last Monday | day | reported | 2026-09-14 | 2026-09-14 |
| 6 | 3 | EV04 | R03 | 2026-08-28 | 12-week course | September 14 for 12 weeks | duration | planned | 2026-09-14 | 2026-12-06 |
| 7 | 6 | EV07 | R06 | 2026-10-10 | review meeting | October 22 | day | planned | 2026-10-22 | 2026-10-22 |
| NA | 5 | EV06 | R05 | 2026-10-05 | pilot lasted | six weeks | duration | reported | NA | NA |
How this differs from parsing one date
TimeML and related standards separate events, time expressions, and the documentβs creation time. This page does the same thing in a small table. It does not train or evaluate a temporal parser, and the constructed normalizations are not independent labels.
A real-text case shows why the table matters. In the inaugural corpus, Lincolnβs 1865 phrase βfour years agoβ has only a speech-year reference if the source records no month or day. The output should retain that year-level precision rather than inventing a day.
What to remember
- The entry date supplies the reference for relative phrases, not the event date.
- A season or month is an interval under a stated convention.
- A day-level event can be a point. A less precise event should not be a point.
- Planned and reported events need a cue besides colour.
- A duration without a start date gets a row but no mark.
Nadiaβs timeline retains the six-week pilot without inventing a date. The pilot remains in the table but off the time scale until a start date is available.
